Progress Tracking

Estimated reading: 4 minutes

Creating Planned Progress Tracking Issue

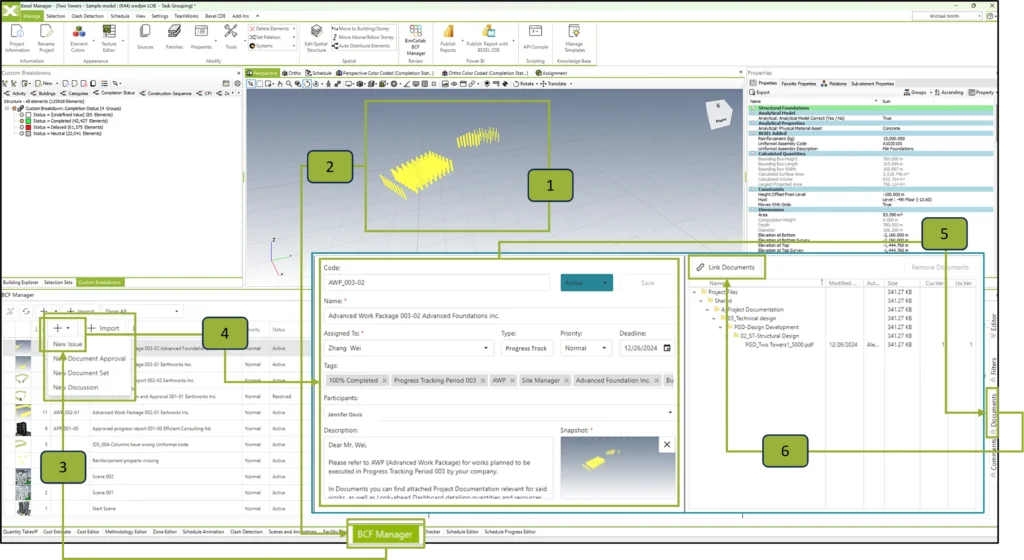

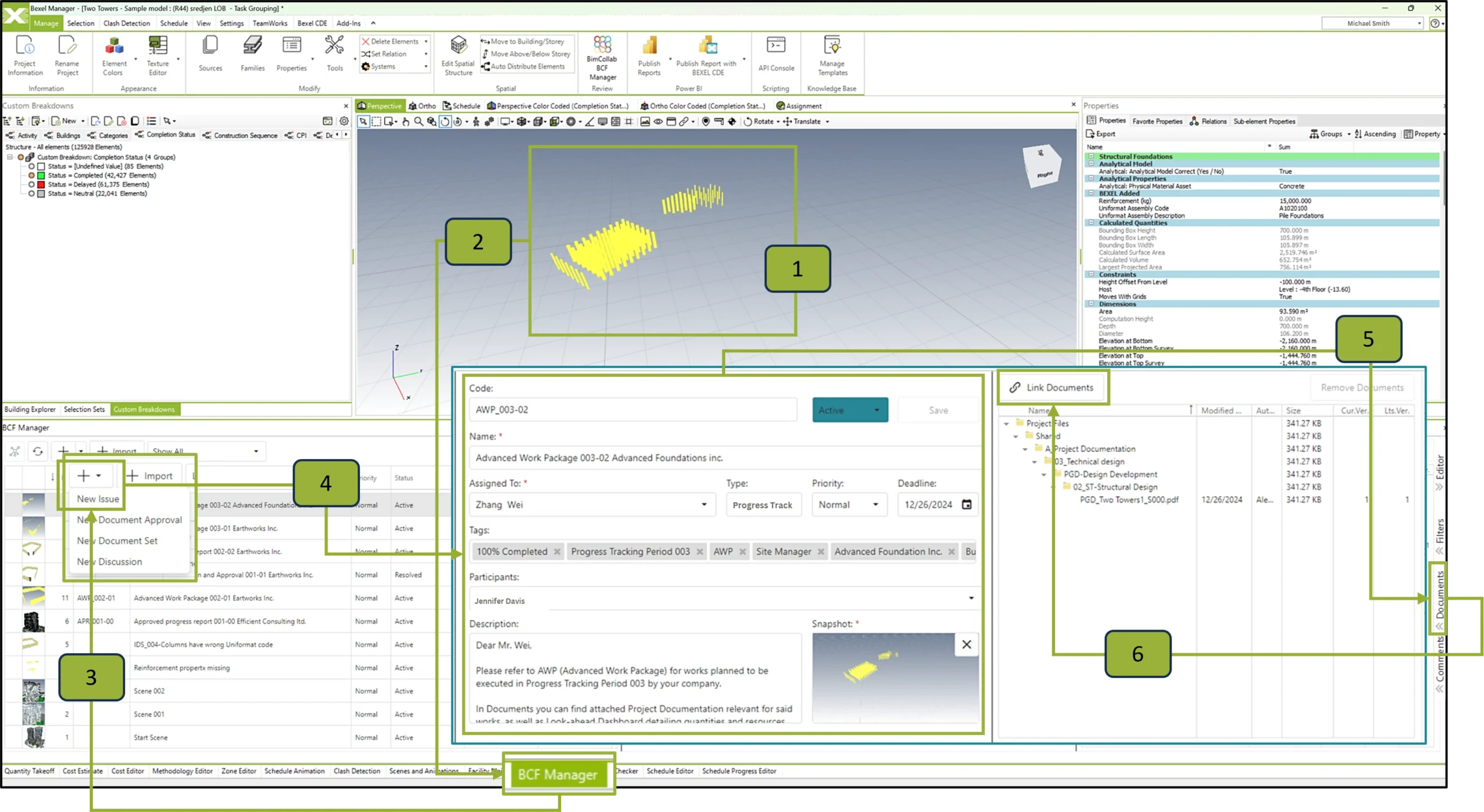

Advanced Workpackage sent by Planner to Site manager with attached Project Design Documentation. BEXEL Manager and BEXEL CDE enable collaboration and communication on progress tracking between stakeholders. The process of sending Advanced Workpackage for works planned to be executed from Planner to Site Manager is described in the steps below:

1. In the BEXEL Manager viewport, isolate and/or select elements planned for execution in the observed period

2. Open BCF Manager module

3. Click on + button to open the dropdown menu and select New Issue option

4. Issue editor opens. Define the issue by filling in the empty fields and selecting appropriate options from the dropdown menus

5. To attach documents relevant to the created issue, hit the Documents editor button

6. In the Documents editor click on Link Documents button to link documentation relevant to the issue

Note

To enable the use of the BCF Manager module in BEXEL Manager, the appropriate CDE project must be selected in the Bexel CDE ribbon bar.

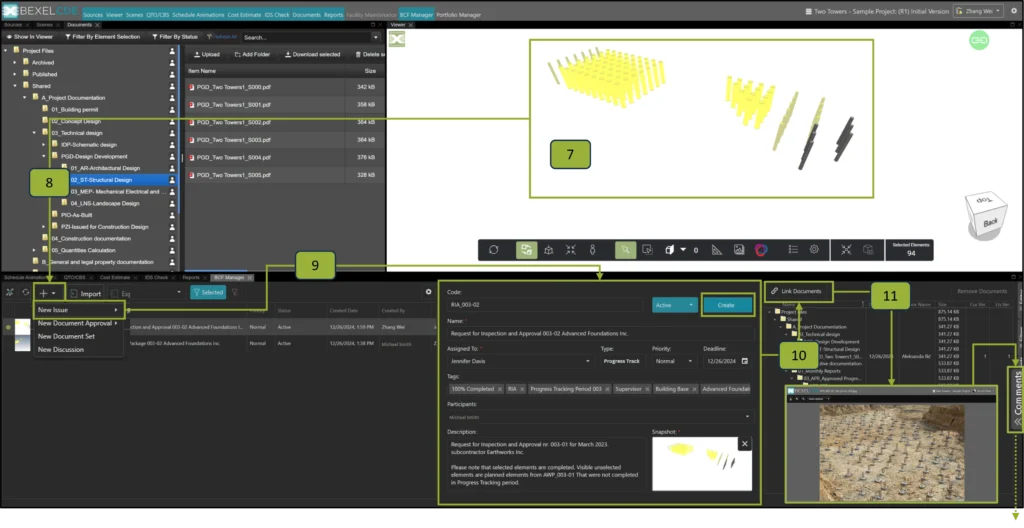

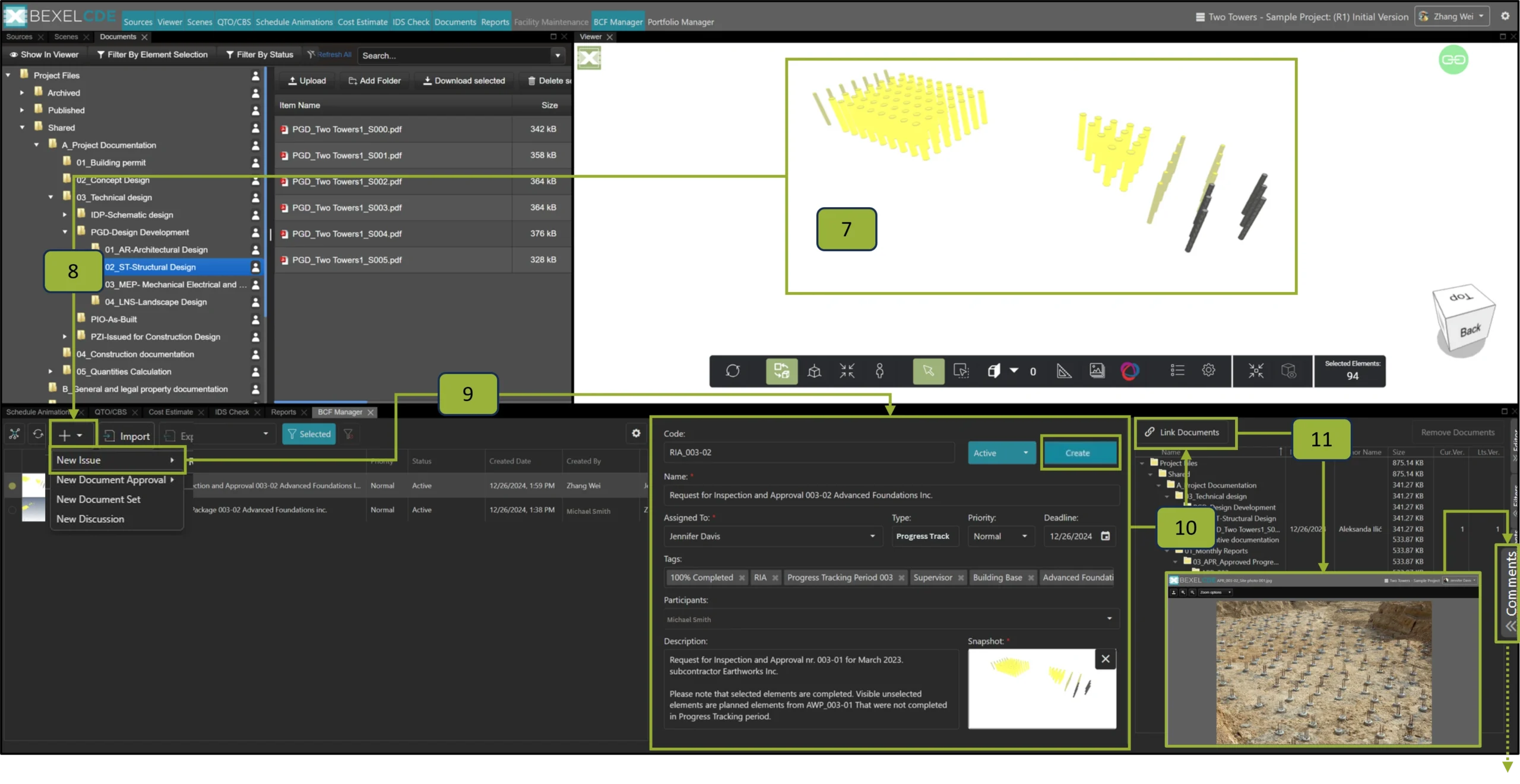

Creating Request for Progress Inspection and Approval

Request for Inspection and Approval sent by Site Manager to Supervisor. On-site photos, videos and scans attached. BEXEL CDE is used for issue inspection and approval. The detailed process of creating the issue for approval is described in the steps below:

7. Isolate and/or select elements for works executed in the observed period

8. In BCF Manager module, select the New Issue option

9. In the Issue editor define the Request for Inspection and Approval issue by filling the empty fields and selecting relevant options from the dropdown menus. Hit Create button to create the issue

10. To attach on-site photos, videos and scans relevant to executed work, hit the Documents editor button and click on Link Documents button

11. In the Link Documents window select the appropriate document to link it to the issue

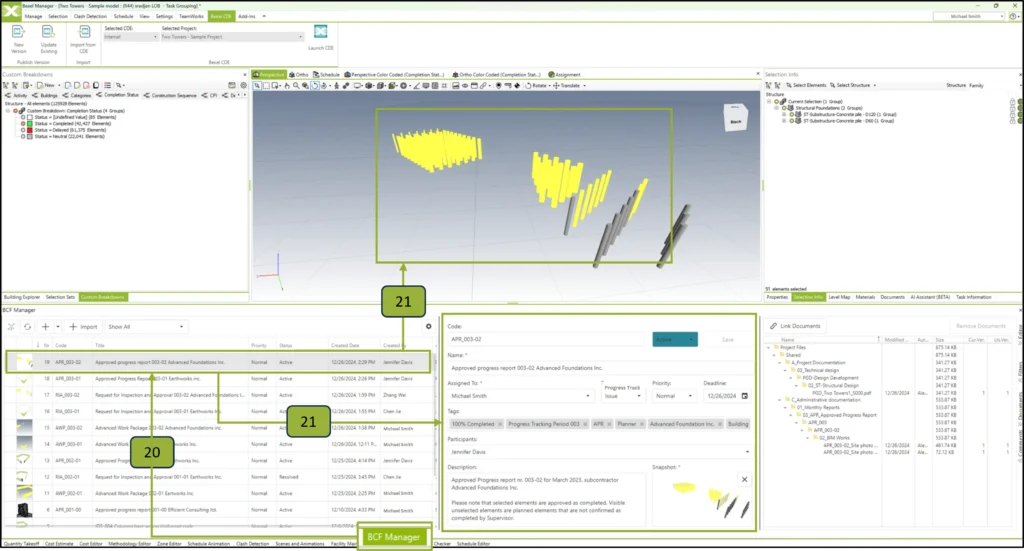

Communicating on Request for Progress Inspection and Approval

Progress tracking Communication – Request for Inspection and Approval sent by Site Manager to Supervisor. On-site photos, videos and scans attached. BEXEL CDE is used for issue inspection and approval by the Supervisor. The detailed process of communication between stakeholders on approval issue is described in the steps below:

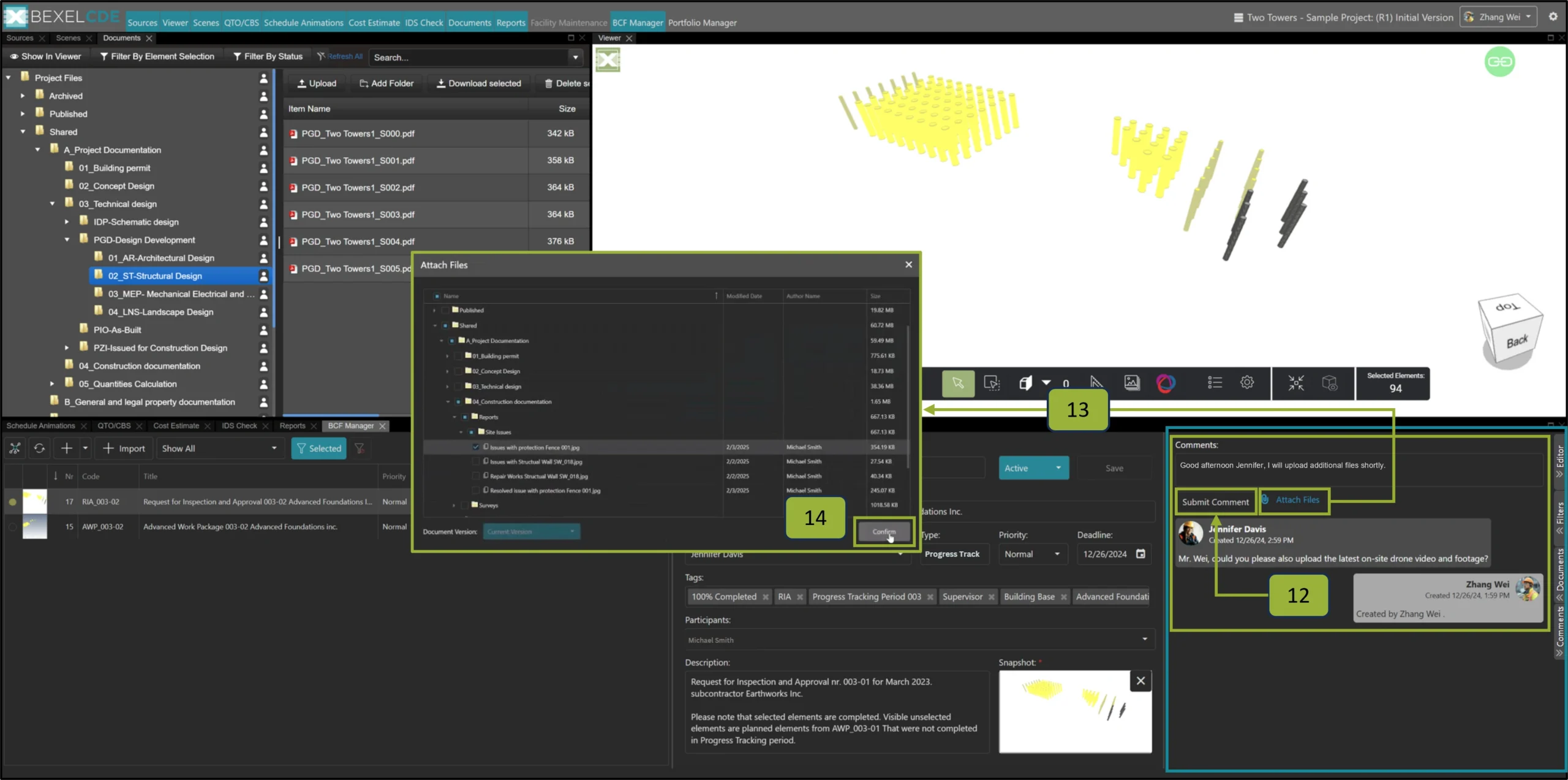

12. Enter Comment editor to communicate further with stakeholders regarding the issue by writing comments in the appropriate field and submitting them by clicking on Submit Comment

13. To add additional documentation, click on the Attach Files button

14. In Attach files window, select files from the list and hit Confirm

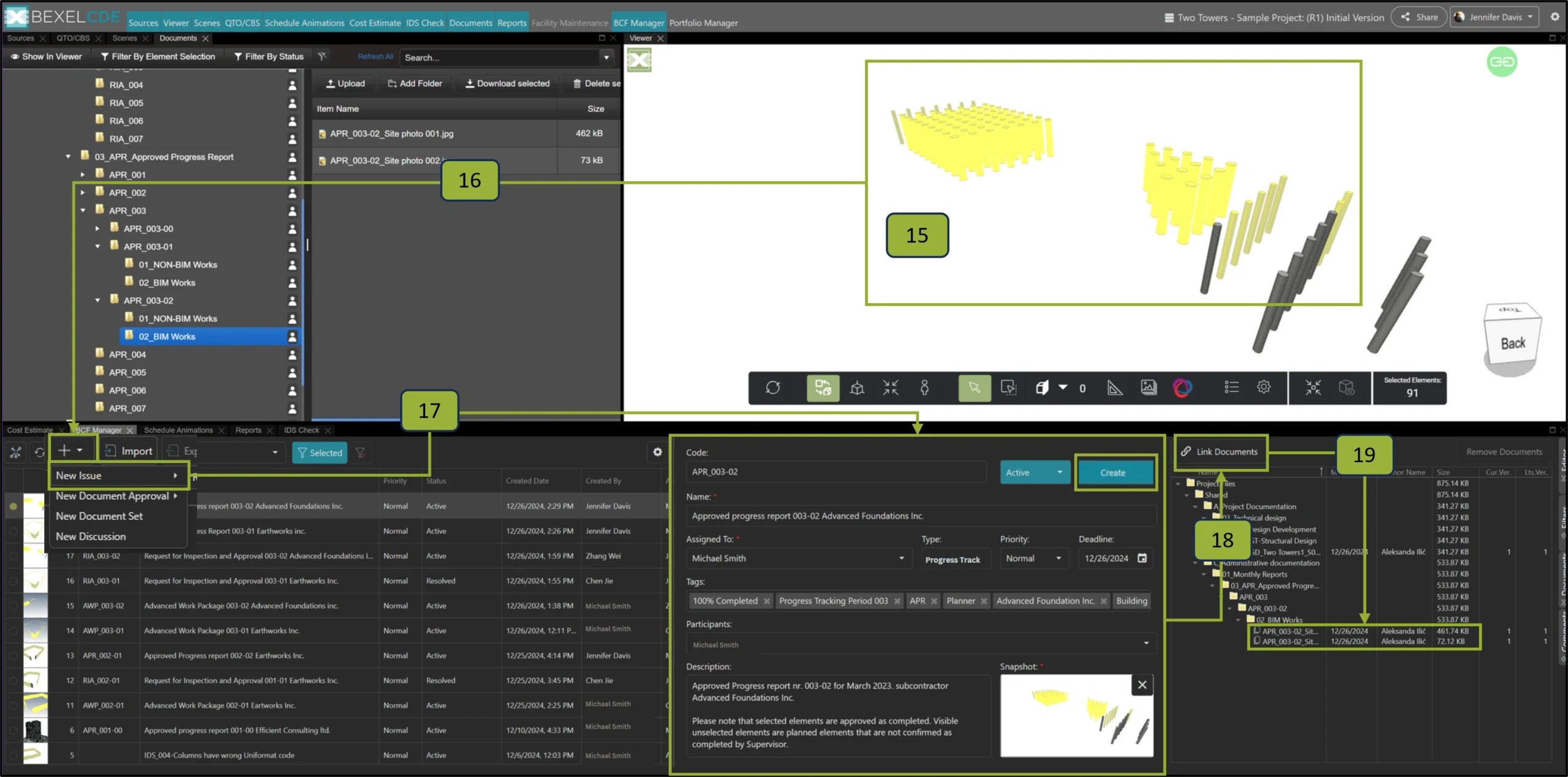

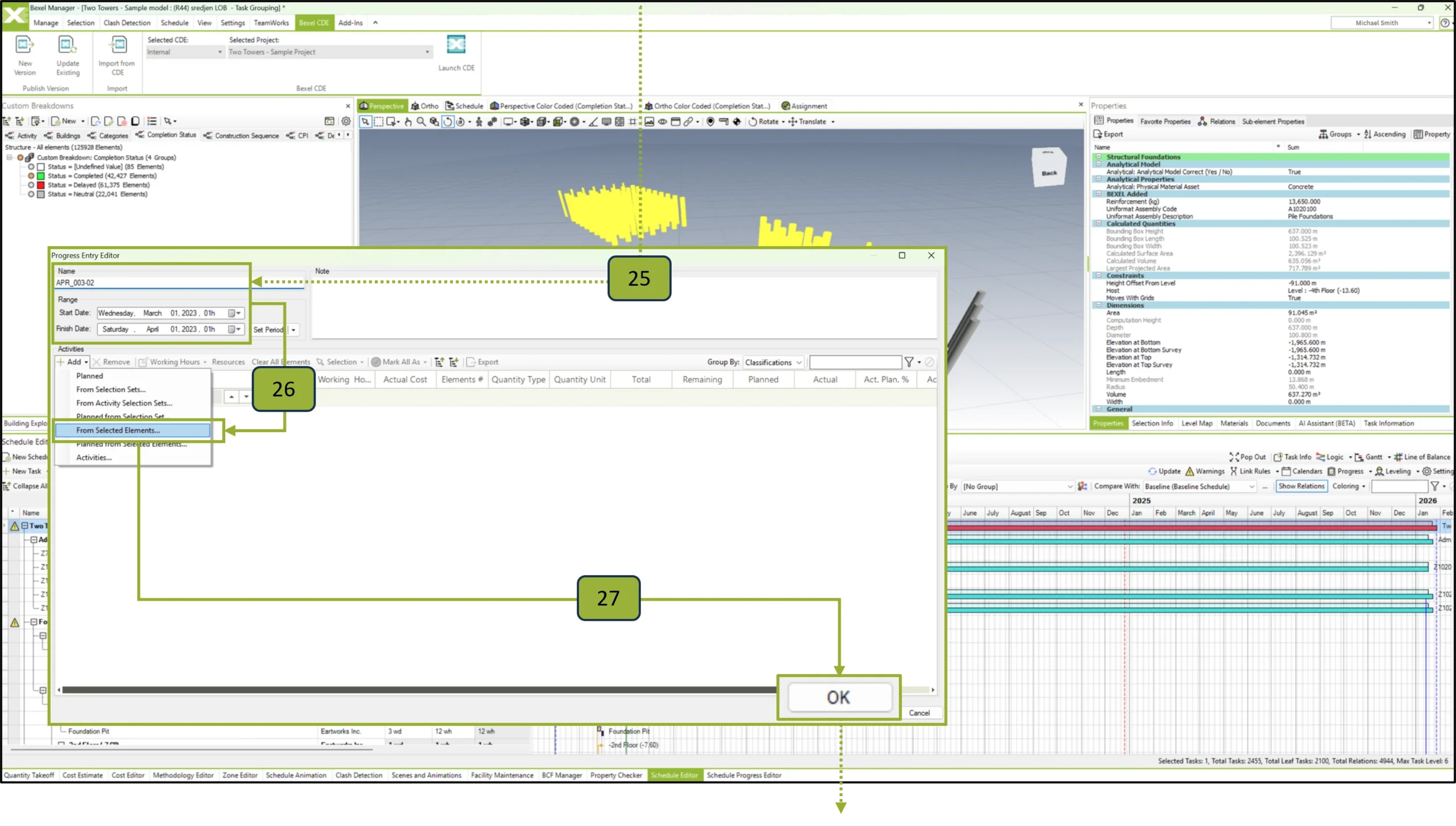

Creating Approved Progress Report

Approved Progress Report sent by Supervisior to Planner with approved elements. After inspecting the issue and further communication with On-site manager, BEXEL CDE is used for creating the issue approval report by the Supervisor. The detailed process of issue approval is described in the steps below:

15. Isolate and/or select elements for approved works for the observed time period

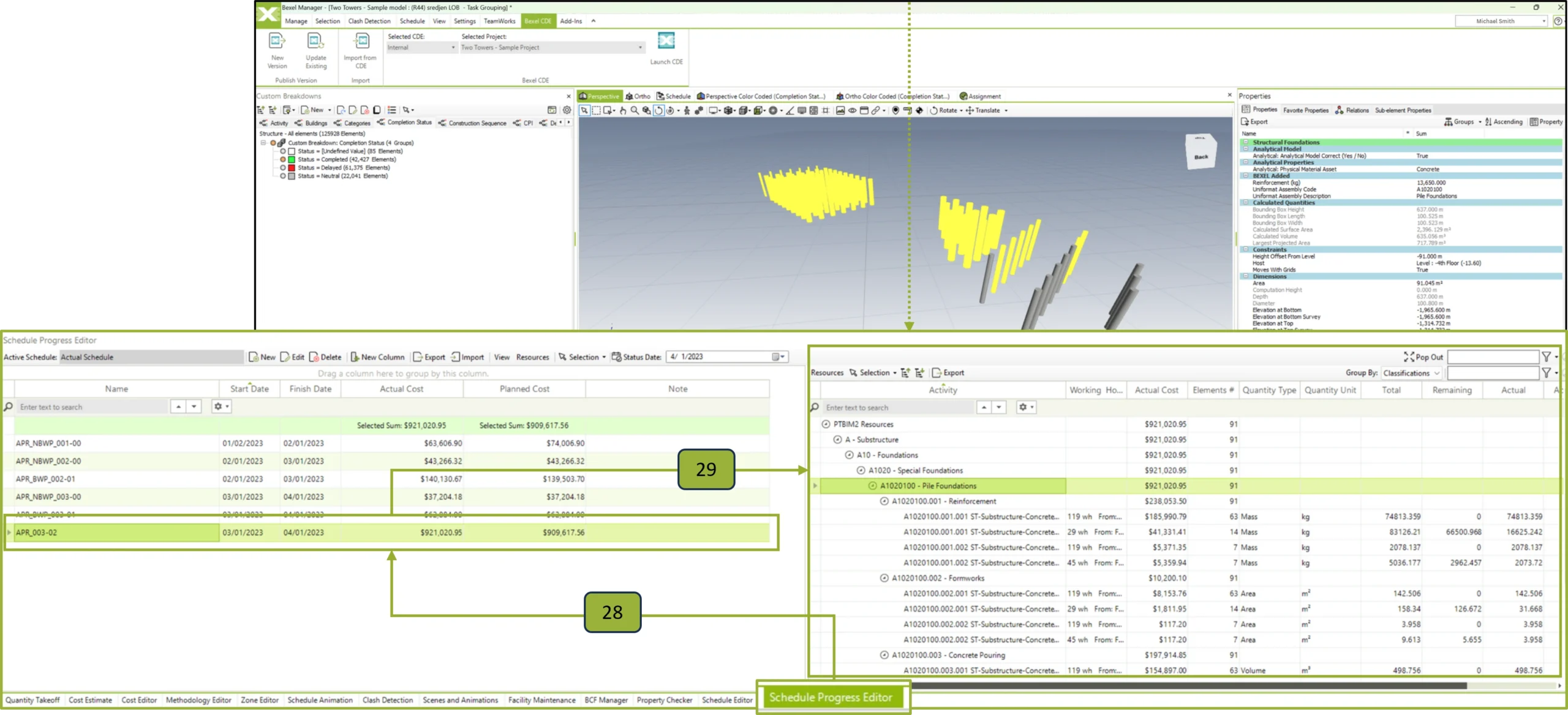

16. In BCF Manager module select the New Issue option

17. In the Issue editor define the Approval Report issue by filling the empty fields and selecting relevant options from the dropdown menus. Hit the Create button to create the issue

18. To attach additional documentation relevant to work approval, hit the Documents editor button and click on the Link Documents button

19. In the Link Documents window, select the appropriate document to link it to the issue

Creating Progress Entry based on Approved Progress Report

Progress tracking Communication – Approved Progress Report – used for Progress Entry by Planner. After Progress Approval Report creation, BEXEL Manager is used for creating a progress update by the Planner. The detailed process of progress entry is described in the steps below:

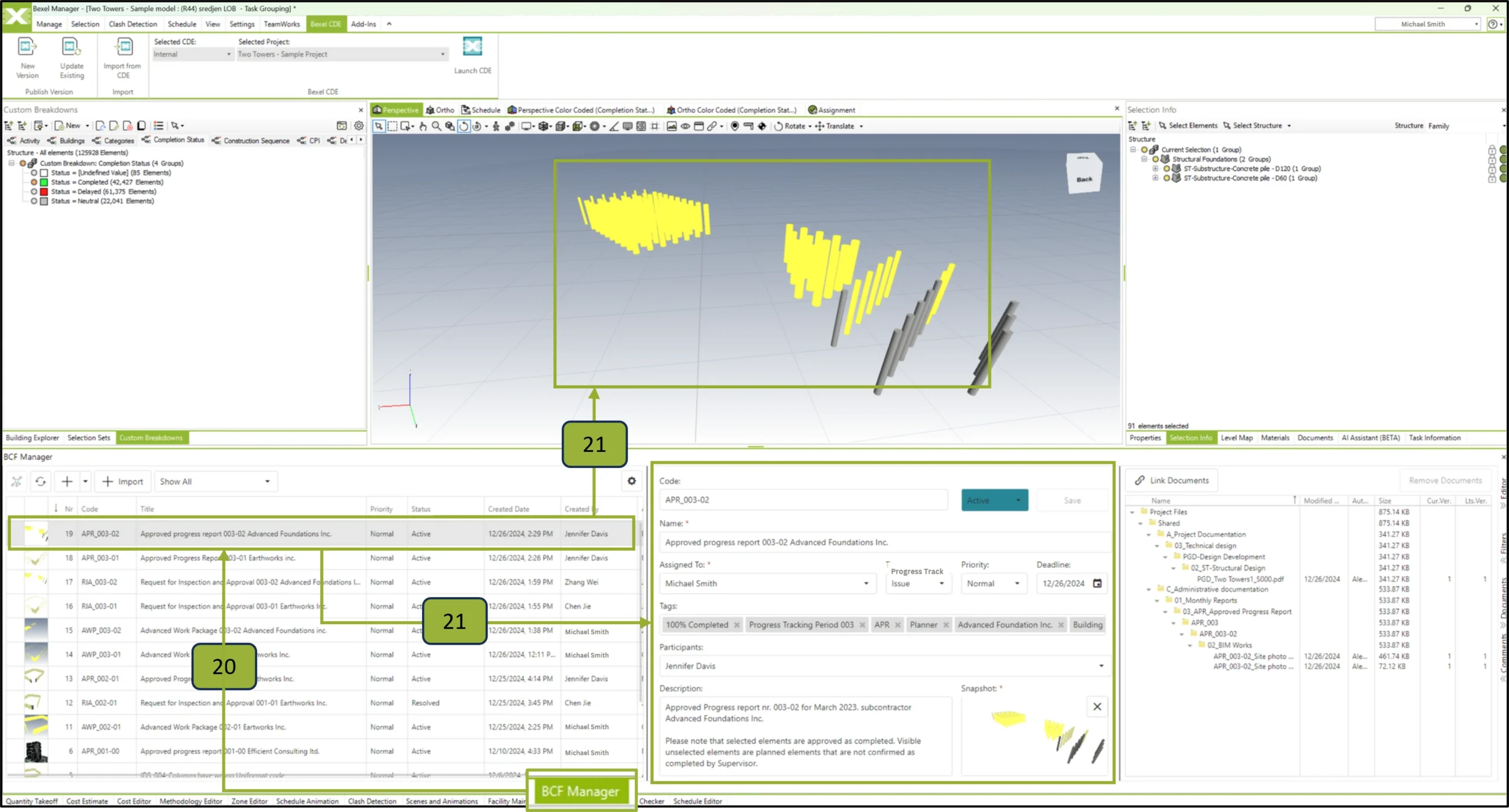

20. In BCF Manager module activate Approved Progress Report by double-clicking on it in the issue list

21. Approved elements and issue details will be shown in the Viewport and Issue editor. Approved construction elements from the entry are automatically selected in the viewport

Note

To enable the use of the BCF Manager module in BEXEL Manager, the appropriate CDE project must be selected in the Bexel CDE ribbon bar.

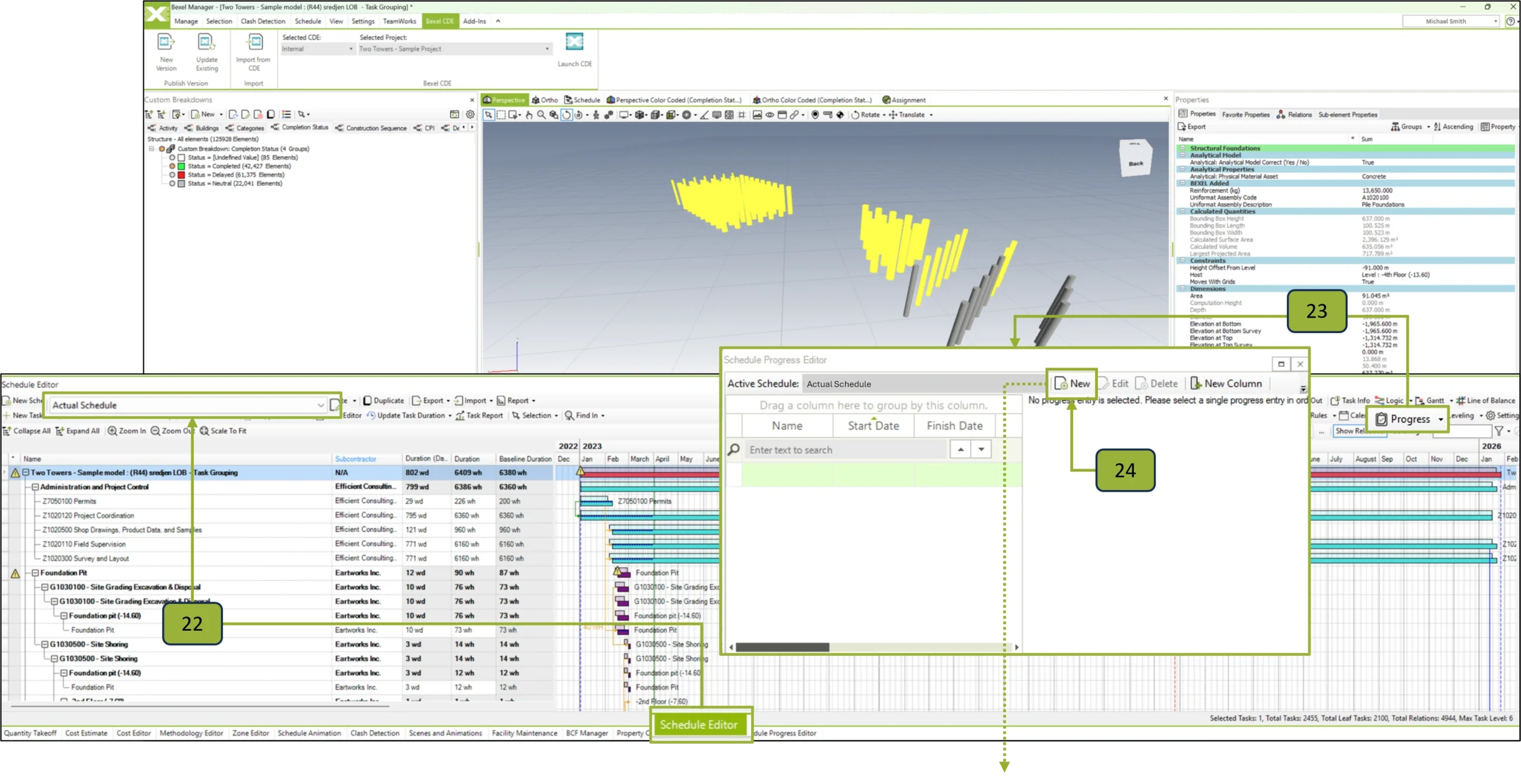

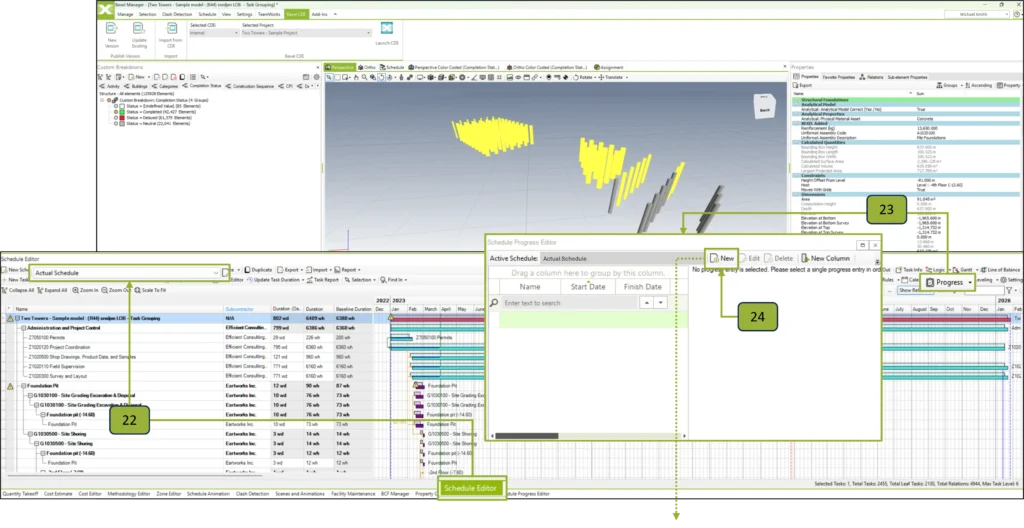

22. To create a progress entry based on selected elements, first activate the Schedule Editor module and select the appropriate construction schedule from the list

23. Click on the Progress button to open Schedule Progress Editor

24. In Schedule Progress Editor click New to create a new progress entry

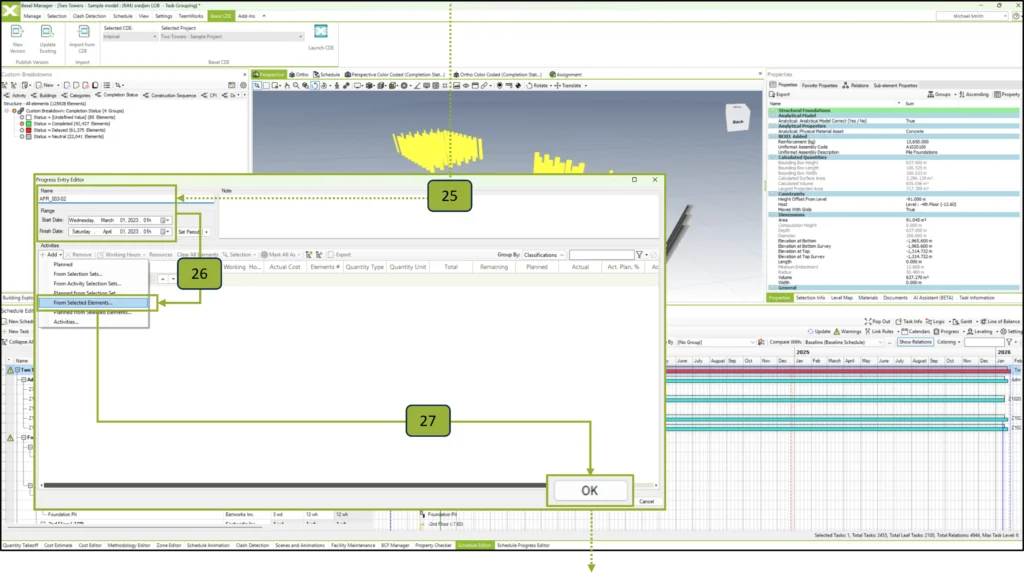

25. In Progress Entry Editor, enter the Name of the approved issue on which the progress entry is based. Choose Start Date and Finish Date for the construction period

26. To create a new entry click Add and select option From Selected Elements

27. Click OK to create a progress entry

28. The list of progress entries is accessed by activating the Schedule Progress editor module

29. Selecting a newly created progress entry from the list automatically opens a detailed view of executed tasks from the active schedule with Export, Group By, Filter and Selection options
